Time Schedule and Object Monitoring Lines

  • Updated

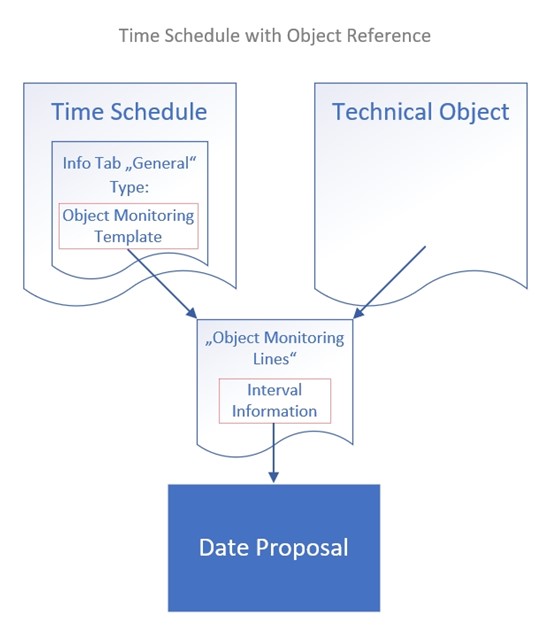

In maintool so called Time Schedules and Object Monitoring Lines exist.

The Time Schedule is seen as a document in which the recurring activity is defined and specified, e.g. Maintenance, Inspection, Testing, etc.

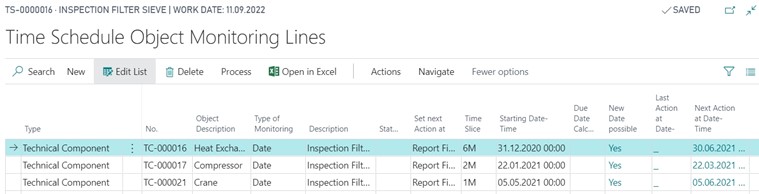

The Object Monitoring Line then maps the connection to the Technical Object. In this way, various objects can be assigned to an activity, e.g. Maintenance, and maintool supports individual time intervals.
